Convenience Stores | Retail Projects
Most remodel plans start with finishes and fixtures. Facilities directors should start with a harder question: can the location keep selling while the work happens?

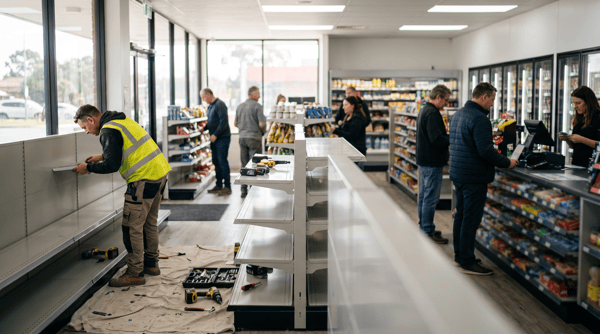

In one convenience store (C-store) remodel Vixxo Facility Solutions executed, a stay-open refresh with foodservice equipment, bean-to-cup coffee, and interior finishes finished in 10 days without shutting the site down. That is the bar when customer experience (CX) and daily revenue cannot pause for construction.
By Vixxo Facility Solutions
|
10 Days To complete stay-open remodel, equipment, and finishes |
0 Days Of full store closure required during the remodel window |
30 - 90 Days Typical compressed remodel window under turnkey project management |
Sources: Vixxo anonymized C-store remodel case study; Retail Remodels Without Revenue Disruption, Vixxo.com, 2026.
Why stay-open remodels are an FM problem, not only a construction problem
A closed C-store loses more than fuel and merchandise sales. It loses the customer experience moments that keep drivers loyal: coffee, foodservice, clean restrooms, and a store that looks ready for business. Facilities management (FM) owns the outcome because the remodel touches revenue-generating equipment and the front-door experience customers judge in seconds. A refresh that looks beautiful on day 11 but starved sales for two weeks failed the facilities brief.
What the 10-day stay-open remodel actually included
A leading C-store operator needed a refresh that supported a broader foodservice push without taking the store offline. Vixxo's Projects team executed a scoped remodel that upgraded the customer journey while dayparts kept running.
| Workstream | What changed | Why FM cared |
|---|---|---|
| Foodservice | Expanded fresh food offering with upgraded display cases | Revenue equipment had to install cleanly without spoiling the daypart |
| Coffee | Bean-to-cup coffee program prioritized in the remodel | Morning rush customer experience depends on uptime, not just new machines |
| Store environment | Wall finishes, restrooms, and cohesive aesthetic refresh | Front-door-in brand standards had to hold during and after work |
| Operations | Store remained open with business as usual | Sales continuity became a project KPI, not an afterthought |
Operator feedback on the project: communication from the Vixxo team kept day-to-day operations running smoothly, and store sales were not adversely affected during the renovation. Staff and customers responded positively to the new look, with leadership expecting a sales lift in the months after reopen quality was achieved without a shutdown.
What made the stay-open window possible
Relative weight of execution factors in a compressed stay-open remodel (illustrative FM priority index).
| Pre-site survey and scope lock |
|
90 |
| Phased work around dayparts |
|
84 |
| Direct-to-site equipment flow |
|
76 |
Priority index (0-100) for facilities leaders running stay-open C-store refreshes. Source: Vixxo Projects Division execution patterns, 2024-2026.
The playbook was not improvisation. Vixxo surveyed the store to lock scope before crews arrived, collaborated with corporate and site operators so no one was surprised mid-shift, and staged equipment so installers were not waiting on freight. That same discipline scales across multi-site portfolios through Vixxo's Projects Division: dedicated project managers, field coordinators, and a vetted service provider (SP) network with reporting at every site. Compressed turnkey remodels typically land in a 30 to 90-day window depending on scope. The 10-day stay-open case shows what is possible when sales continuity is a hard constraint.
How FM leaders should brief the next refresh wave
Before the next capital wave, write stay-open rules into the statement of work (SOW): protected dayparts, phased zones, photo-ready open/close checks, and change-order rules that do not freeze the floor. Then connect remodel closeout to ongoing FM so new assets enter preventive maintenance (PM) immediately. VixxoVerify can audit project and post-handover invoices for total spend protection across parts, labor, and trip fees, so the capital win does not leak in the first 90 days.
| Explore Vixxo store refresh and remodel projects |
Frequently Asked Questions
What is a stay-open store remodel in facilities management?
A stay-open remodel is a refresh or renovation planned so the location continues serving customers during construction. Work is phased by zone and daypart, critical equipment is sequenced carefully, and sales continuity is treated as a project key performance indicator (KPI) alongside schedule and budget.
How did Vixxo complete a C-store remodel in 10 days without closing?
Vixxo locked scope with a pre-project survey, coordinated corporate and site operators, staged equipment for direct-to-site install, and phased finishes and foodservice work so the store could remain open. The anonymized case included foodservice upgrades, bean-to-cup coffee, restroom and aesthetic refreshes, and continuous communication so day-to-day operations were not disrupted.
When should a retailer choose a refresh instead of a full gut remodel?
Choose a stay-open refresh when the layout can largely remain, the goal is CX and equipment uplift, and revenue loss from a shutdown would erase the capital return. Choose a deeper remodel when structural, code, or concept changes require closure or major demolition. Many portfolios run light refreshes on a shorter cycle and major remodels on a longer capital cycle.
What should FM leaders measure during a stay-open remodel?
Track daily sales versus baseline, hours any critical CX zone is offline, change-order count and dollars, photo-verified readiness at open and close, and on-time milestone completion. After handover, enroll new assets into PM and apply spend protection so the remodel investment holds in year one.
Sources: C-Store Foodservice Revolution / Vixxo remodel case study, Vixxo.com | Retail Remodels Without Revenue Disruption, Vixxo.com | Vixxo Projects Division | The Refresh Revolution, Vixxo.com.
